Here’s a plan to find creek and river contamination and fix it. “This Nine-Element Plan for Cat Creek, HUC 0311020303, facilitates finding and fixing contamination that is getting into the Withlacoochee River upstream from Valdosta, Georgia, from Cat Creek and its feeder creeks in Berrien and Lowndes Counties, Georgia.”
Cat Creek Nine Element Plan, Find and fix contamination into Withlacoochee River, WWALS, VSU, USDA NRCS 2026-05-14
Lowndes County Comprehensive Plan Update
This Plan is featured on two pages of the 2026 Comprehensive Plan Update for Lowndes County and the Cities of Dasher, Hahira, Lake Park, Remerton, & Valdosta.
The Lowndes County Commission will vote tomorrow, Tuesday, July 28, 2026, at 5:30 PM, on transmitting that update to the state of Georgia.
WWALS is also mentioned a few other places in that Update, such as under Natural Resources, Opportunities & Existing Resources, “WWALS has a water quality testing program that trains people how to conduct water tests following spills.”
And under Natural Resource, Policies, “Lowndes County and the Cities should collaborate with local outdoor groups, such as WWALS, to market and promote local outdoor events and cleanups.”
Executive Summary

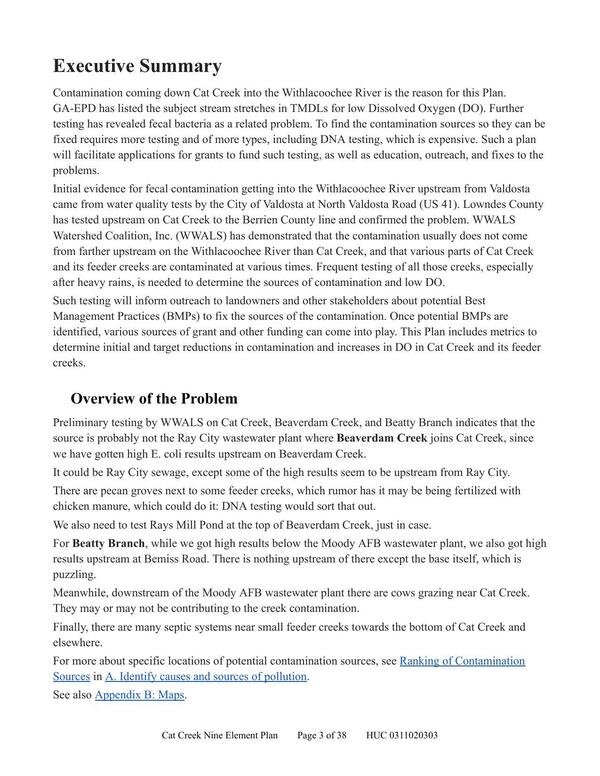

Contamination coming down Cat Creek into the Withlacoochee River is the reason for this Plan. GA-EPD has listed the subject stream stretches in TMDLs for low Dissolved Oxygen (DO). Further testing has revealed fecal bacteria as a related problem. To find the contamination sources so they can be fixed requires more testing and of more types, including DNA testing, which is expensive. Such a plan will facilitate applications for grants to fund such testing, as well as education, outreach, and fixes to the problems.
Initial evidence for fecal contamination getting into the Withlacoochee River upstream from Valdosta came from water quality tests by the City of Valdosta at North Valdosta Road (US 41). Lowndes County has tested upstream on Cat Creek to the Berrien County line and confirmed the problem. WWALS Watershed Coalition, Inc. (WWALS) has demonstrated that the contamination usually does not come from farther upstream on the Withlacoochee River than Cat Creek, and that various parts of Cat Creek and its feeder creeks are contaminated at various times. Frequent testing of all those creeks, especially after heavy rains, is needed to determine the sources of contamination and low DO.
Such testing will inform outreach to landowners and other stakeholders about potential Best Management Practices (BMPs) to fix the sources of the contamination. Once potential BMPs are identified, various sources of grant and other funding can come into play. This Plan includes metrics to determine initial and target reductions in contamination and increases in DO in Cat Creek and its feeder creeks.

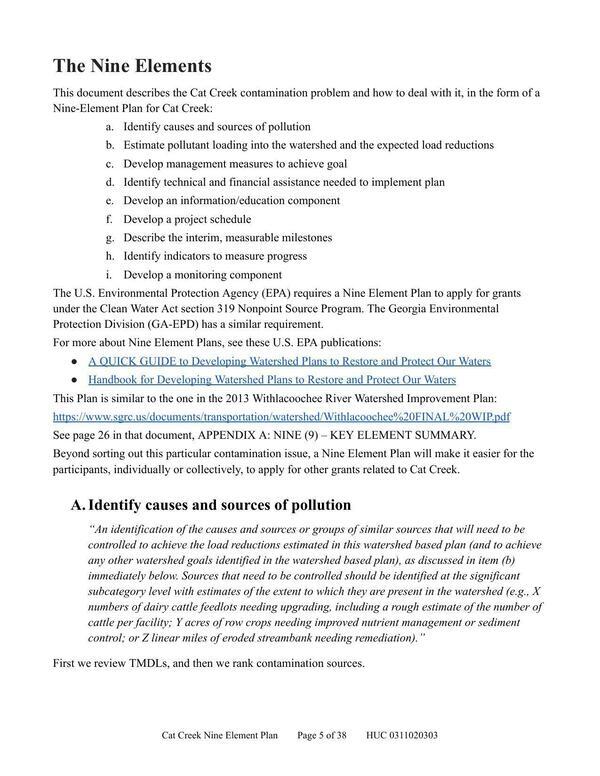

The Nine Elements
This document describes the Cat Creek contamination problem and how to deal with it, in the form of a Nine-Element Plan for Cat Creek:
- Identify causes and sources of pollution
- Estimate pollutant loading into the watershed and the expected load reductions

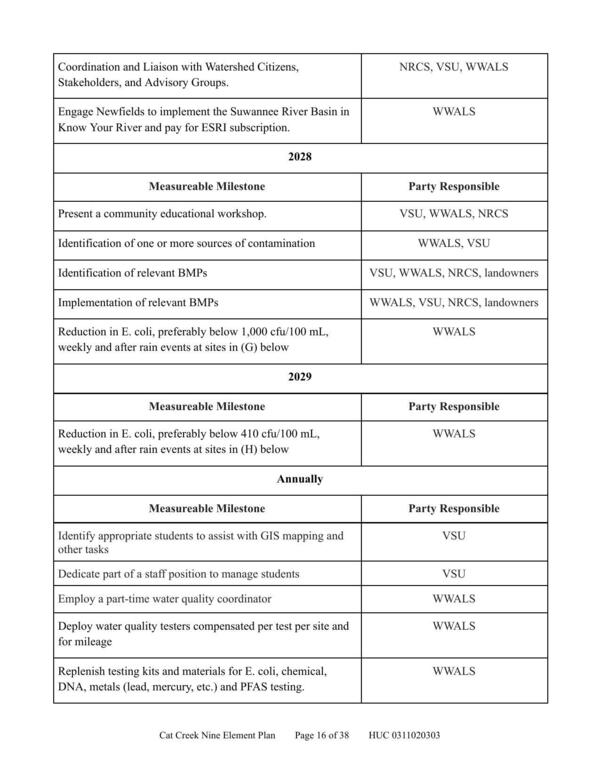

- Develop management measures to achieve goal
- Identify technical and financial assistance needed to implement plan
- Develop an information/education component
- Develop a project schedule
- Describe the interim, measurable milestones
- Identify indicators to measure progress
- Develop a monitoring component
The U.S. Environmental Protection Agency (EPA) requires a Nine Element Plan to apply for grants under the Clean Water Act section 319 Nonpoint Source Program. The Georgia Environmental Protection Division (GA-EPD) has a similar requirement.
-jsq, John S. Quarterman, Suwannee RIVERKEEPER®
You can help with clean, swimmable, fishable, drinkable, water in the 10,000-square-mile Suwannee River Basin in Florida and Georgia by becoming a WWALS member today!
https://wwals.net/donations/

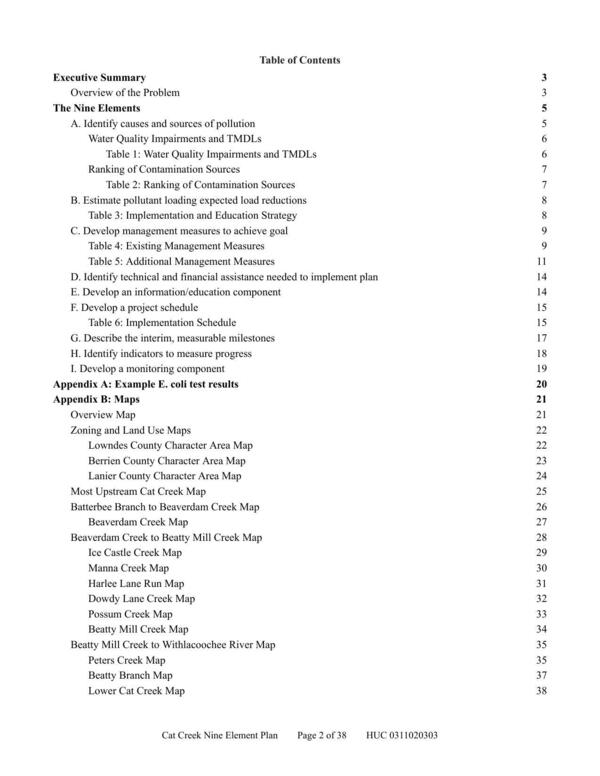

2026-05-14–Cat-Creek-Nine-Element-Plan
Cat Creek Nine Element Plan
PDF
Executive Summary & Overview of the Problem
The Nine Elements, A. Identify indicators to measure progress

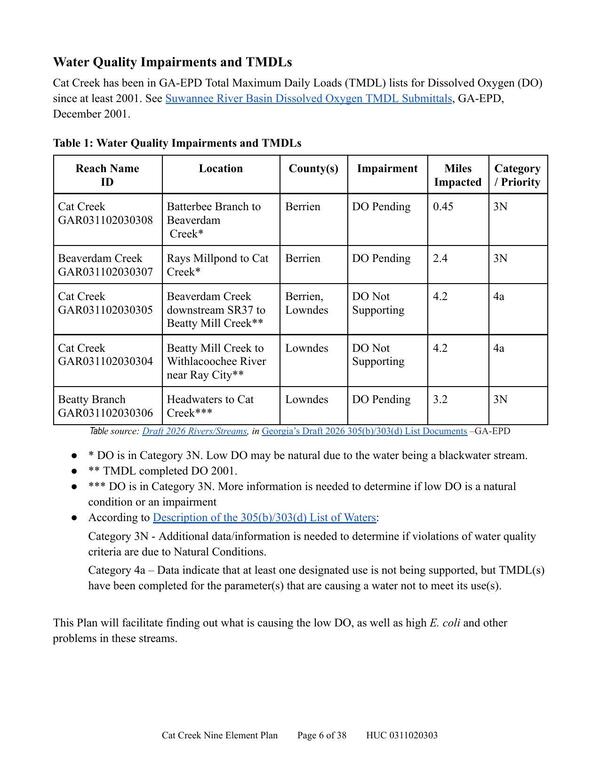

Table 1: Water Quality Impairments and TMDLs

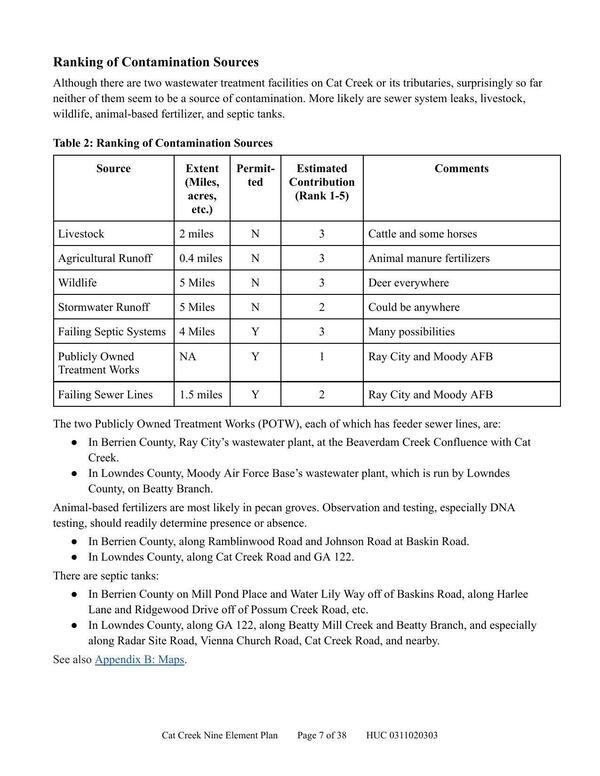

Table 2: Ranking of Contamination Sources

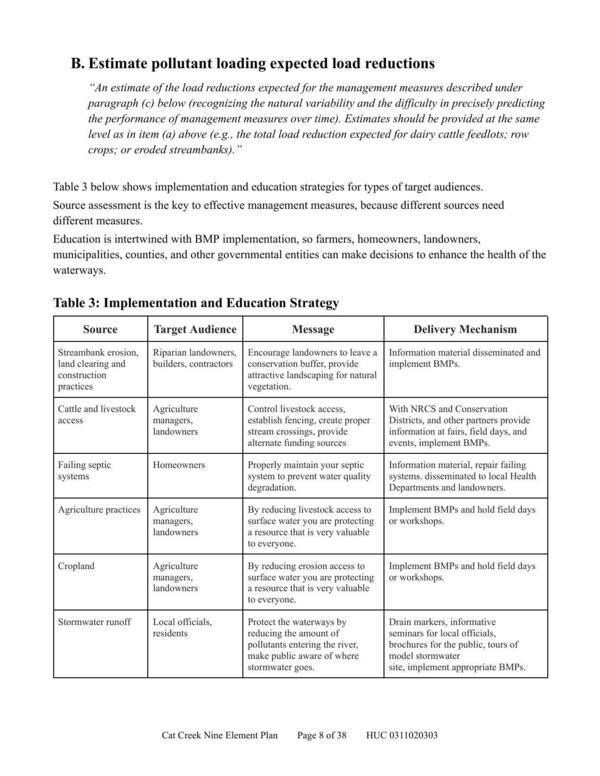

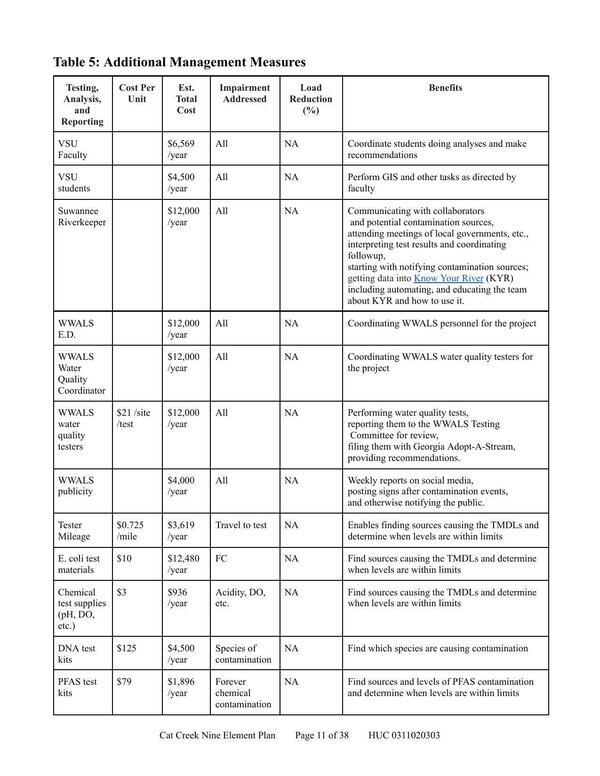

B. Estimate pollutant loading expected load reductions; Table 3: Implementation and Education Strategy

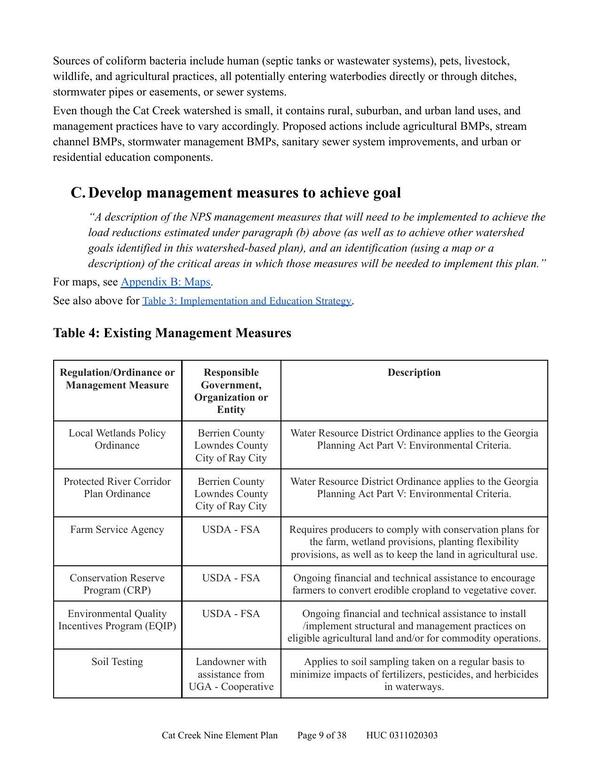

C. Develop management measures to achieve goal; Table 4: Existing Management Measures
Table 5: Additional Management Measures

D. Identify technical and financial assistance needed to implement plan; E. Develop an information/education component

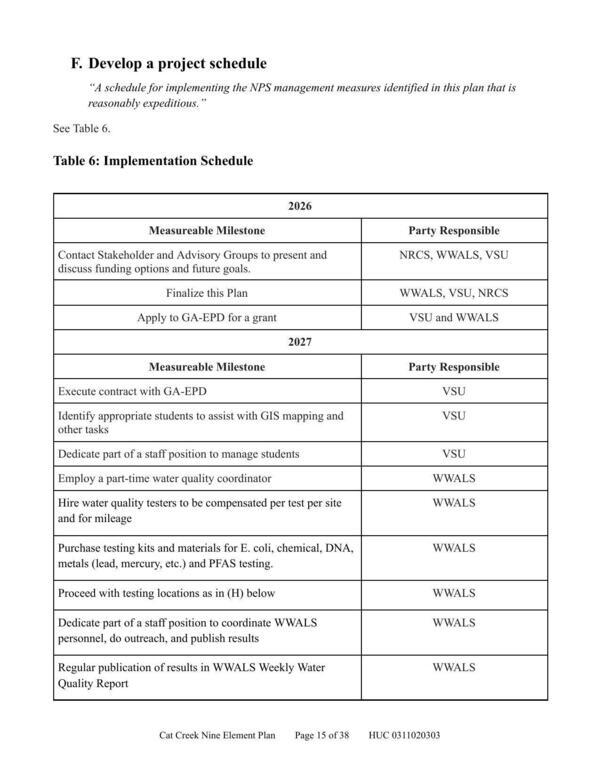

F. Develop a project schedule; Table 6: Implementation Schedule

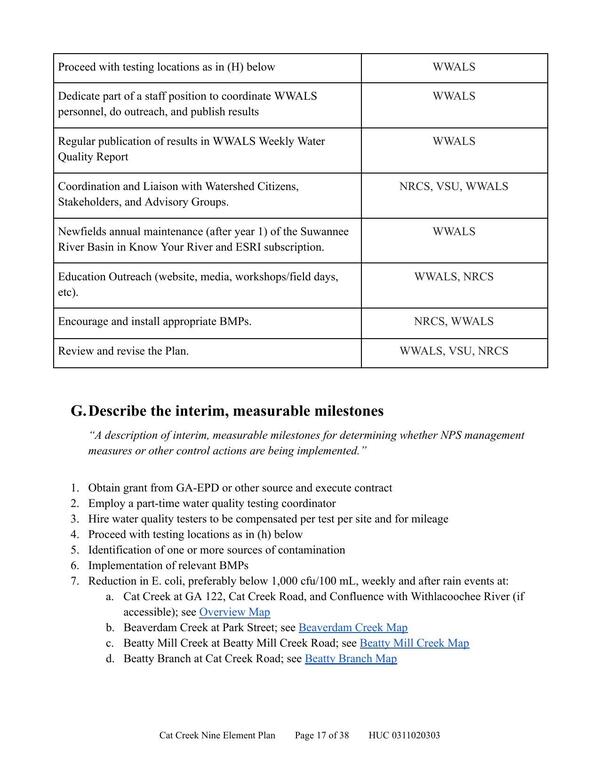

G. Describe the interim, measurable milestones

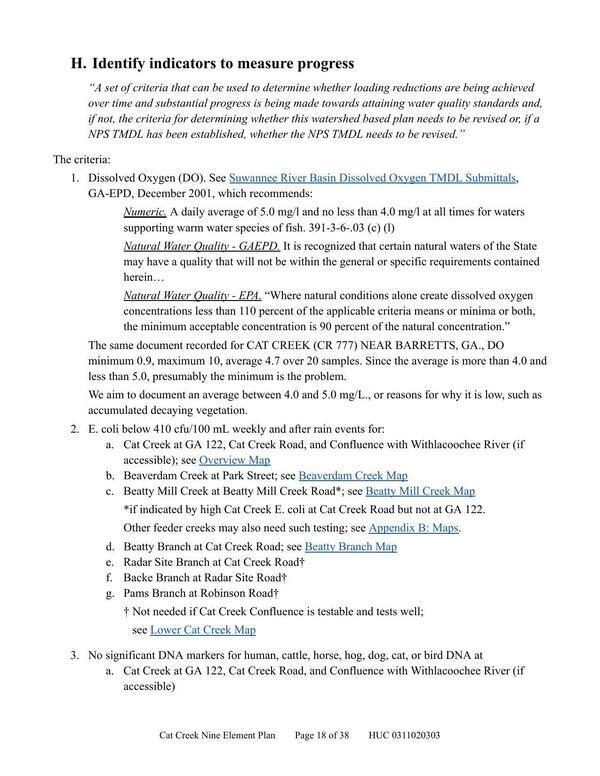

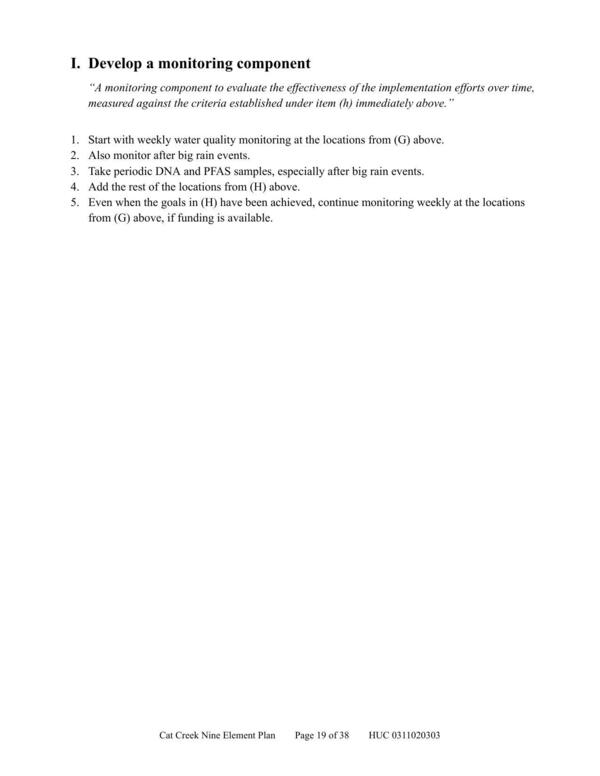

H. Identify indicators to measure progress
I. Develop a monitoring component
AppA

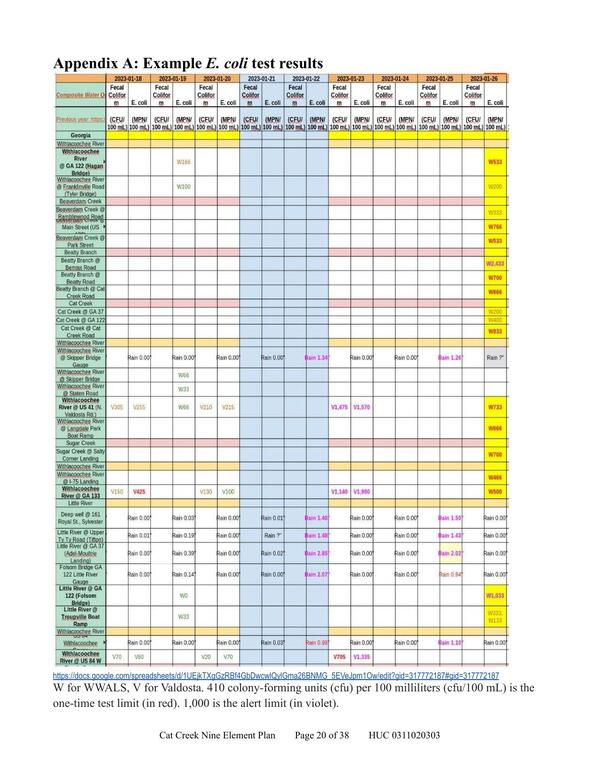

Appendix A: Example E. coli test results
AppB

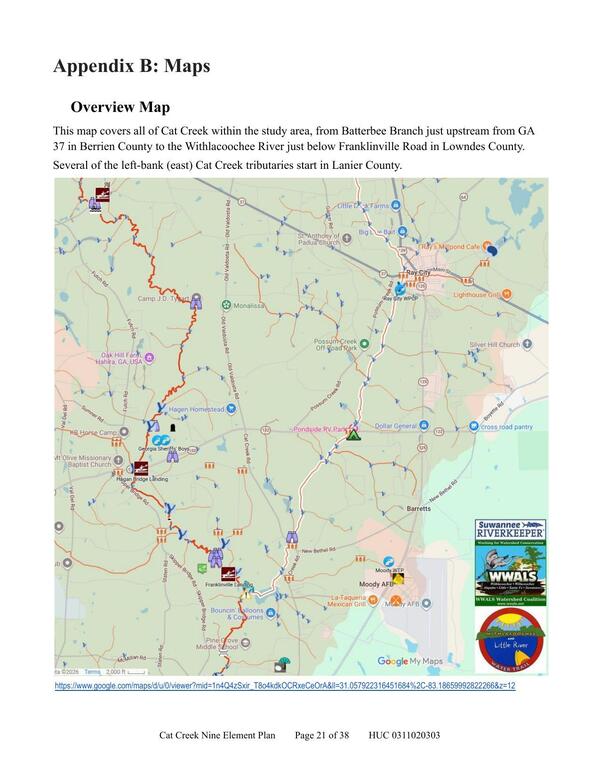

Appendix B: Maps; Overview Map

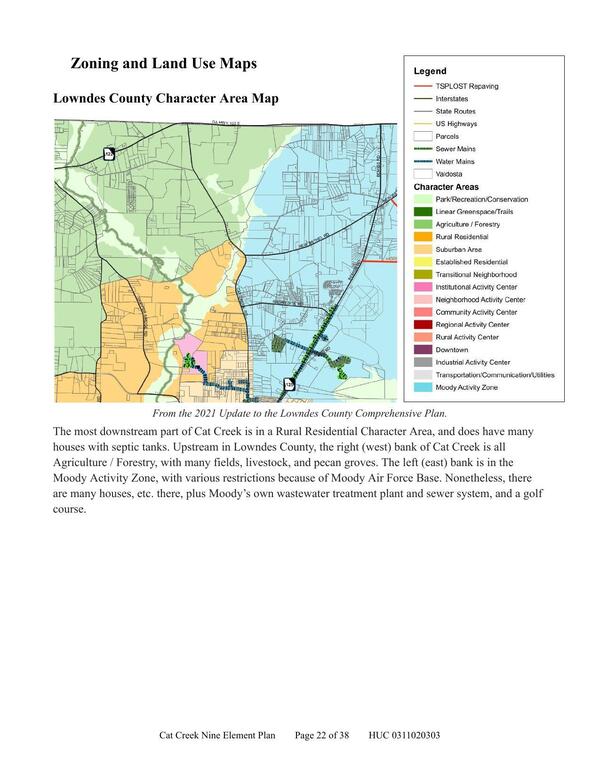

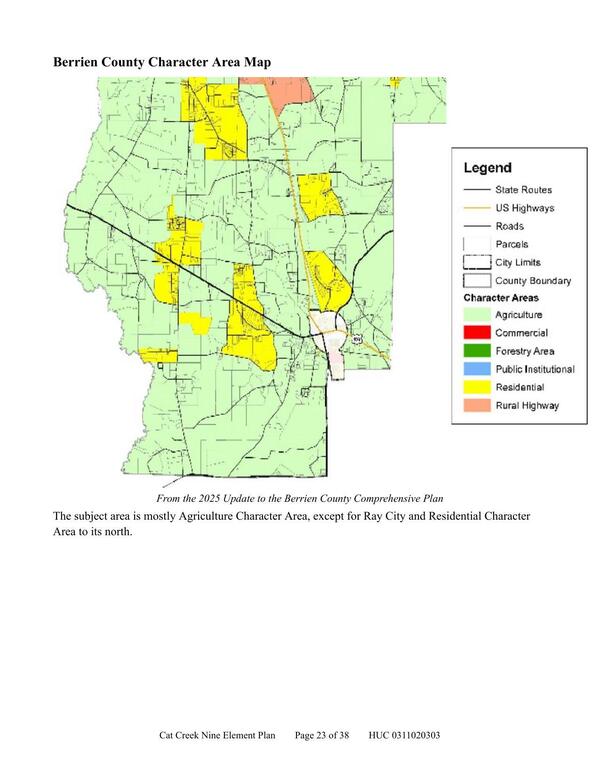

Lowndes County Character Area Map
Berrien County Character Area Map

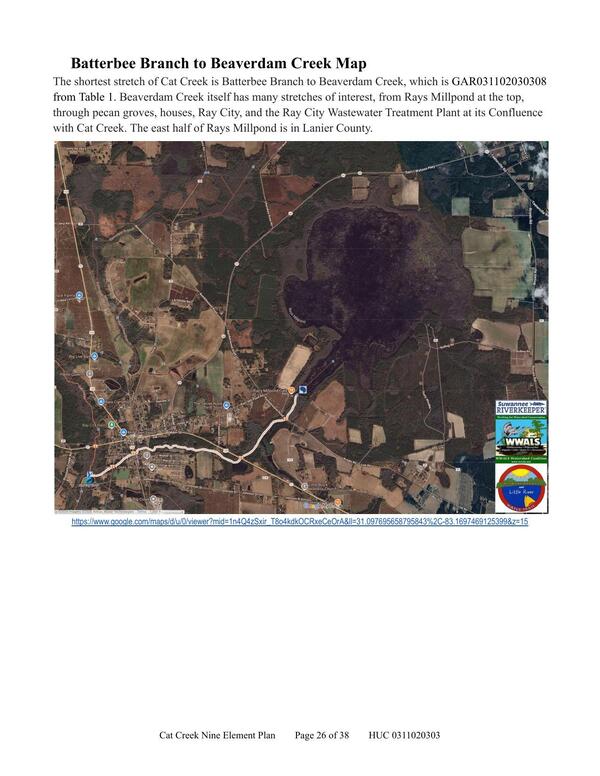

Lanier County Character Area Map
Batterbee Branch to Beaverdam Creek Map
Beaverdam Creek to Beatty Mill Creek Map
Beatty Mill Creek to Withlacoochee River Map
LCP
2026 Comprehensive Plan Update for Lowndes County and the Cities of Dasher, Hahira, Lake Park, Remerton, & Valdosta

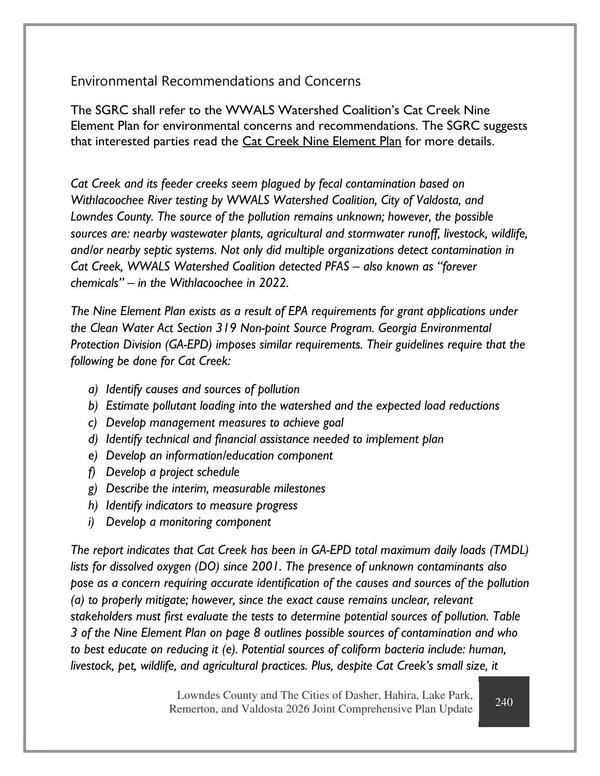

WWALS Cat Creek Nine Element Plan

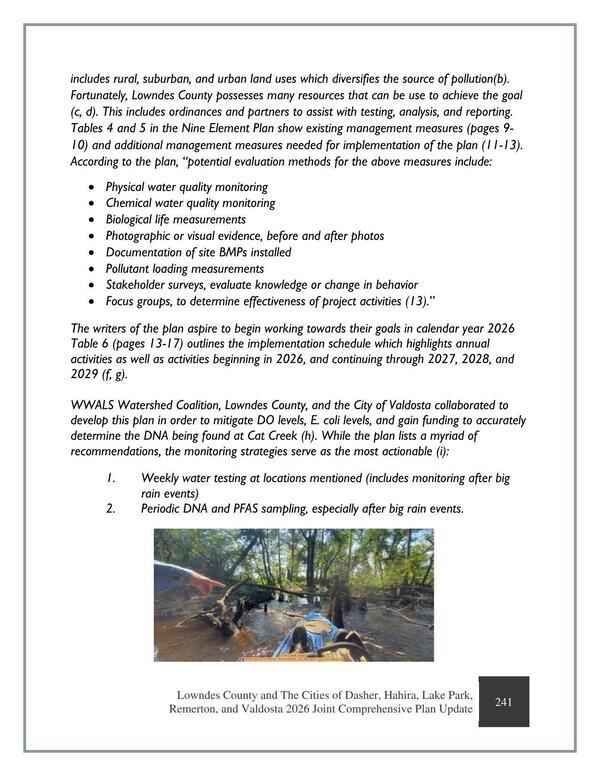

Physical water quality monitoring
Short Link:

![[Table of Contents]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0002.jpg)
![[Page 4]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0004.jpg)
![[Page 10]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0010.jpg)
![[Page 12]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0012.jpg)
![[Page 13]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0013.jpg)
![[Page 16]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0016.jpg)

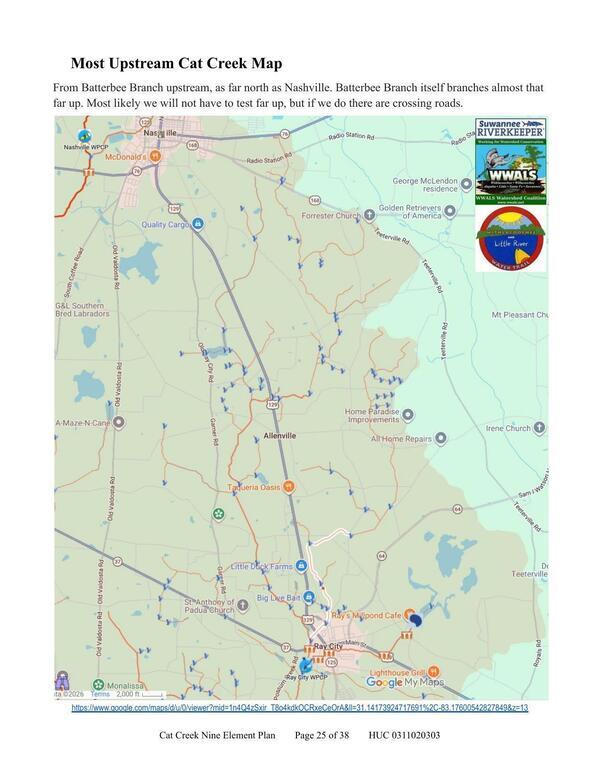

![[Most Upstream Cat Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0025.jpg)
![[Beaverdam Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0027.jpg)

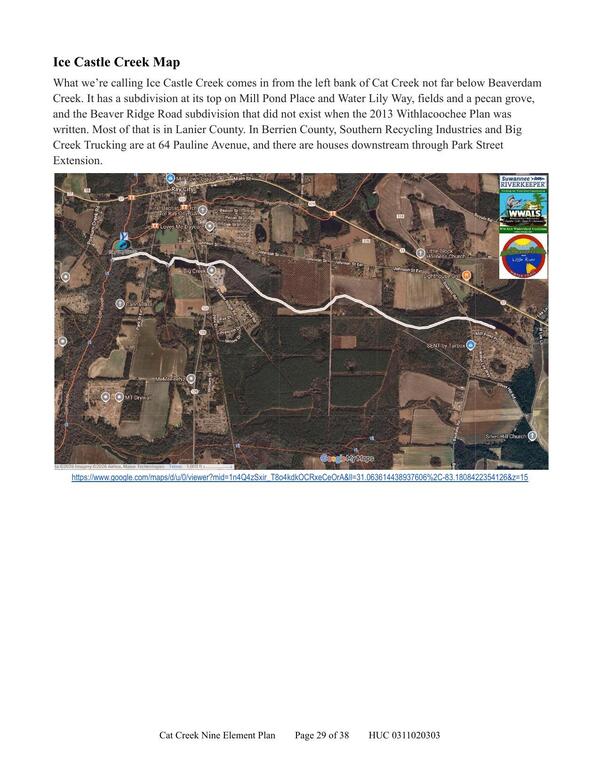

![[Ice Castle Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0029.jpg)

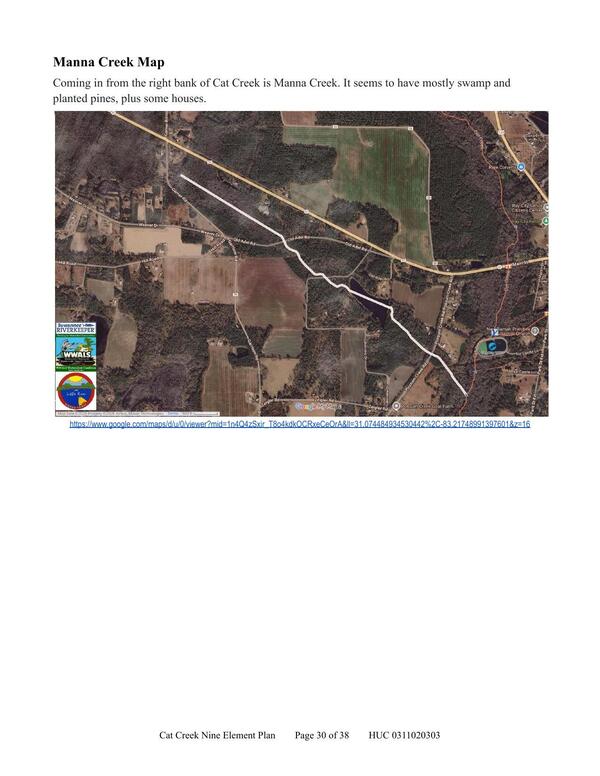

![[Manna Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0030.jpg)

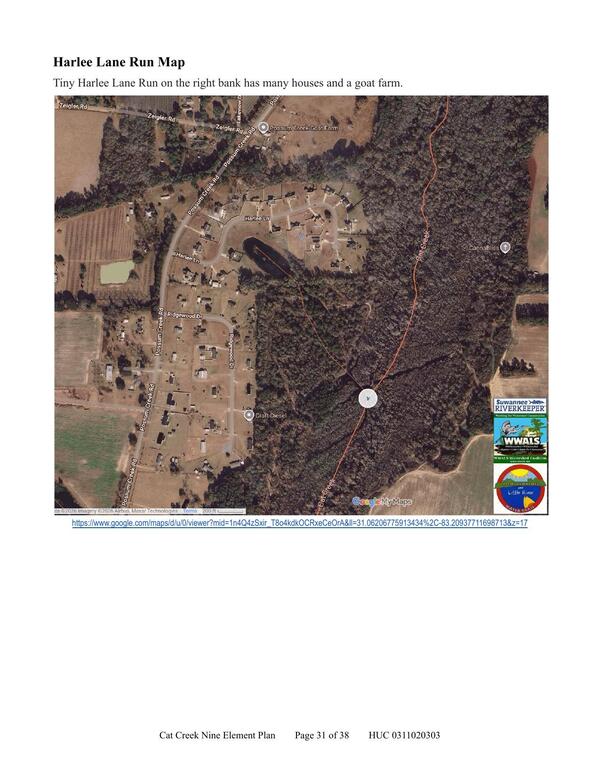

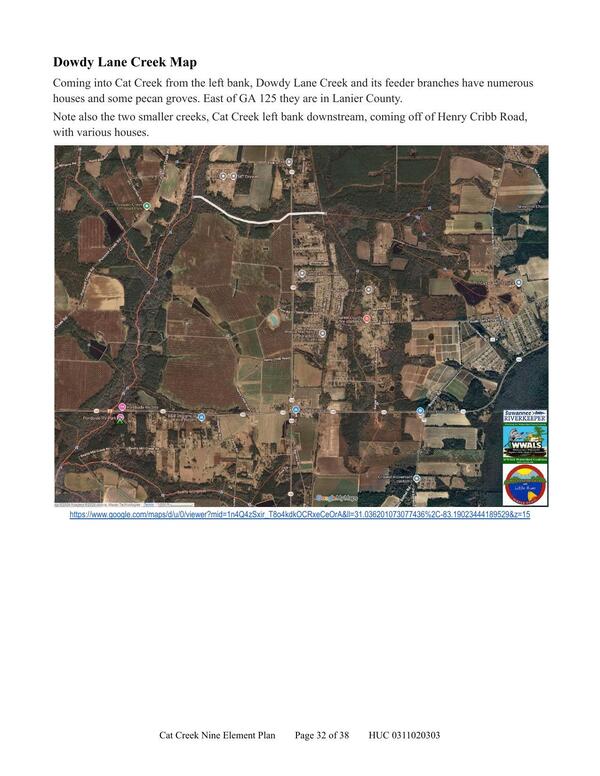

![[Harlee Lane Run Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0031.jpg)
![[Dowdy Lane Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0032.jpg)

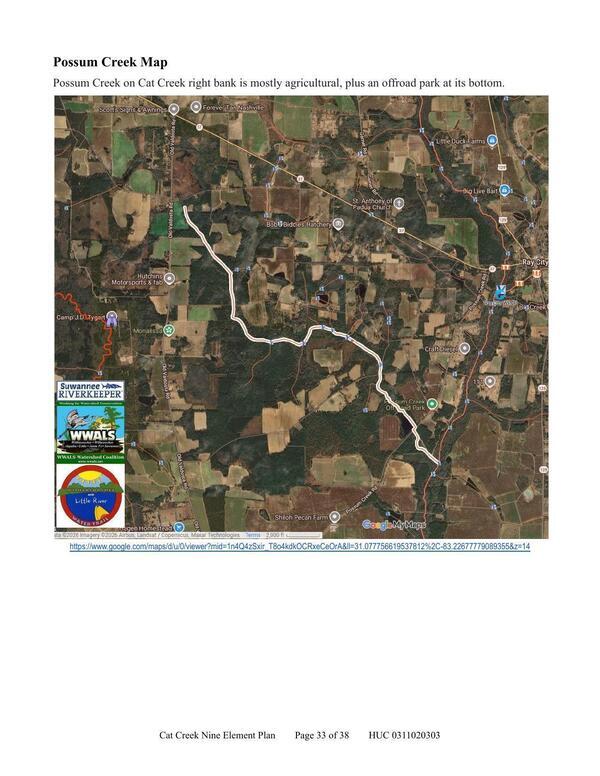

![[Possum Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0033.jpg)

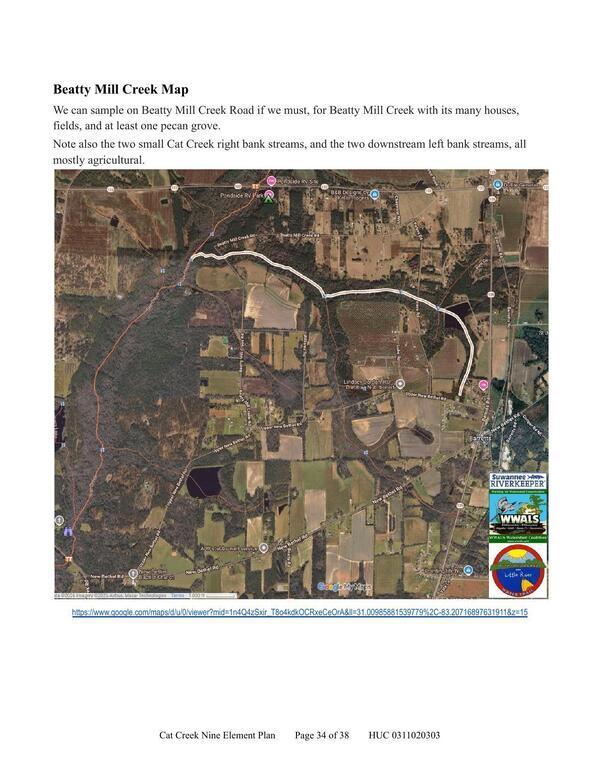

![[Beatty Mill Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0034.jpg)

![[Peters Creek Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0036.jpg)

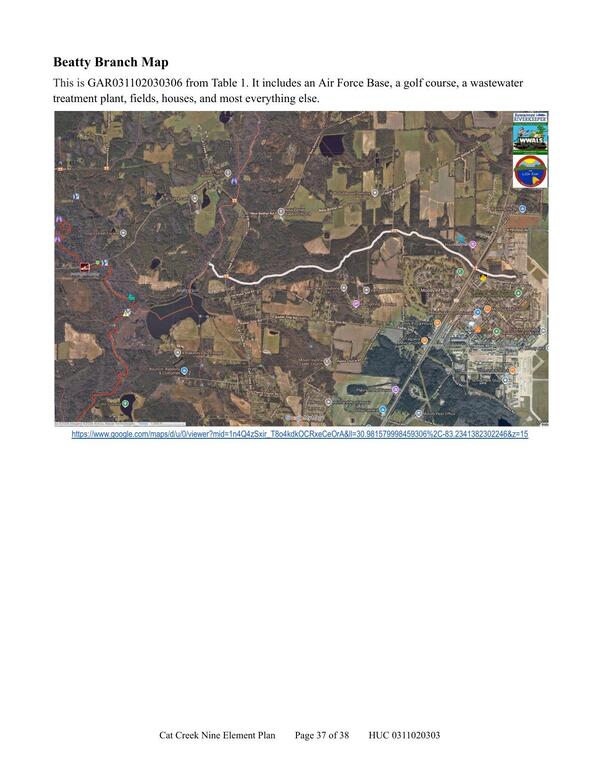

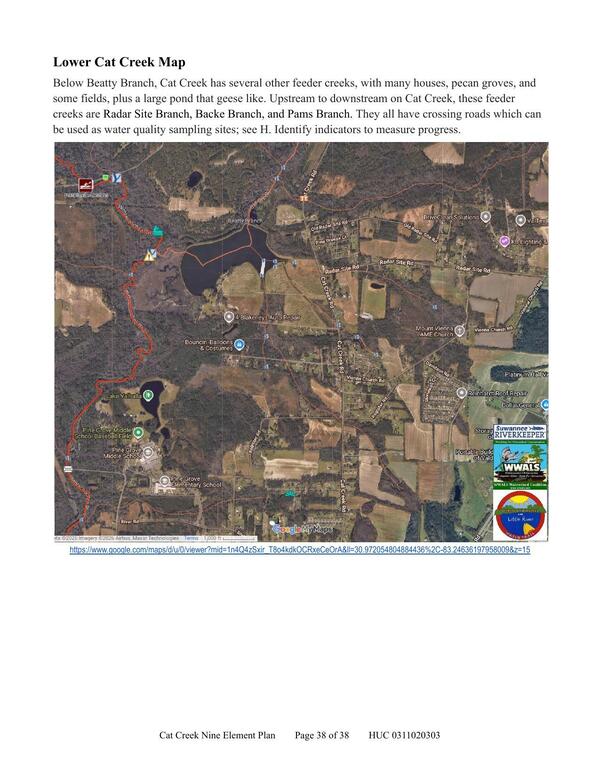

![[Beatty Branch Map]](https://www.wwals.net/pictures/2026-05-14--cat-creek-nine-element-plan/2026-05-14--Cat-Creek-Nine-Element-Plan-0037.jpg)
